Opening Day Is the Wrong Place to Start Your Renewal Calendar

A practical renewal calendar that works backward from opening day and gives every milestone an owner and release gate.

Club managers build a renewal calendar together in a bright clubhouse office.

Many renewal calendars begin with a date someone wants to send an email. That skips the work the email depends on: approved prices, package rules, clean balances, tested forms, staff answers, and a clear response path when a family cannot complete the process.

Start with the first day a member must arrive with a usable account. Work backward through staff rehearsal, reminder waves, early-renewal windows, configuration, policy approval, and data review. Put an owner and a release condition beside every milestone.

The number of weeks will differ by club. The sequence matters more than a universal date. A smaller year-round organization may use a short cycle; a seasonal club with board approvals and returning staff may need several months.

Build the decision around the club’s real work

The strongest plan starts with one ordinary transaction, the people who touch it, the rules they apply, and the record that should remain when the work is done. Use the sections below as a working session with the employees and volunteers who run the process. Write down assumptions, unresolved questions, and owners as you go.

1. Define what “ready on opening day” means

Renewal is not complete merely because a payment succeeded. Decide what a renewed household must be able to do: enter the facility, sign required forms, register for programs, reserve spaces, add guests, or view current balances.

List the records and decisions behind those actions. Give each readiness condition an owner and a fallback for exceptions.

Questions to answer:

  • What must members do?
  • Which forms are required?
  • What status permits access?
  • What remains optional?
  • Who resolves an exception?

The calendar aims at a usable member experience rather than at a campaign launch.

2. Place staff rehearsal before member release

The first time staff see the renewal should not be when a member calls. Schedule a practice period with sample households, ordinary renewals, credits, failed payments, package changes, and incomplete waivers.

Ask front-desk, membership, and finance staff to perform their parts using their actual roles. Capture confusing labels and unclear handoffs as launch blockers, not training failures.

Questions to answer:

  • Who practices?
  • Which cases are included?
  • Are real roles used?
  • Where are questions recorded?
  • Who approves corrections?

The people answering questions can recognize the member’s state and choose the approved next action.

Renewal timeline working backward from opening day to approved rules.
Work backward from the first day members need a ready account.

3. Build reminder waves around decisions

A reminder should help a specific group take a specific action. Separate members who have not started, households with an incomplete step, people awaiting club approval, and accounts that need a finance decision.

Write each message after the audience rule exists. Include the relevant deadline and next step without implying that a pending status is a failure.

Questions to answer:

  • Who receives each message?
  • What state qualifies?
  • What action is requested?
  • What deadline applies?
  • How can members get help?

Members receive useful guidance, and staff do not have to explain why the message did not match the account.

4. Approve prices and package rules before configuration

A package is more than a price. It carries eligibility, included people, dates, guest rules, discounts, billing behavior, and renewal treatment. Capture those decisions in one approved source.

Configure from the approved record and require a second review for material fields. PoolPulse connects membership packages with invoices, recurring billing, and renewal reminders ; test the exact rules your club needs.

Questions to answer:

  • Who is eligible?
  • What dates apply?
  • What billing rule applies?
  • Which benefits are included?
  • Who reviews setup?

The configuration reflects policy instead of turning an unfinished draft into member-facing behavior.

5. Review balances and credits before segmentation

An old credit, refund, write-off, or disputed charge can change what a family sees at renewal. Create a finance review window before audiences are finalized.

Resolve items through the club’s approved process and record the outcome on the account. Do not hide unresolved balances merely to make the renewal list look cleaner.

Questions to answer:

  • Which credits remain?
  • Which refunds are pending?
  • What is disputed?
  • Who may adjust?
  • When is the review complete?

Renewal messages and amounts begin from an account state finance can explain.

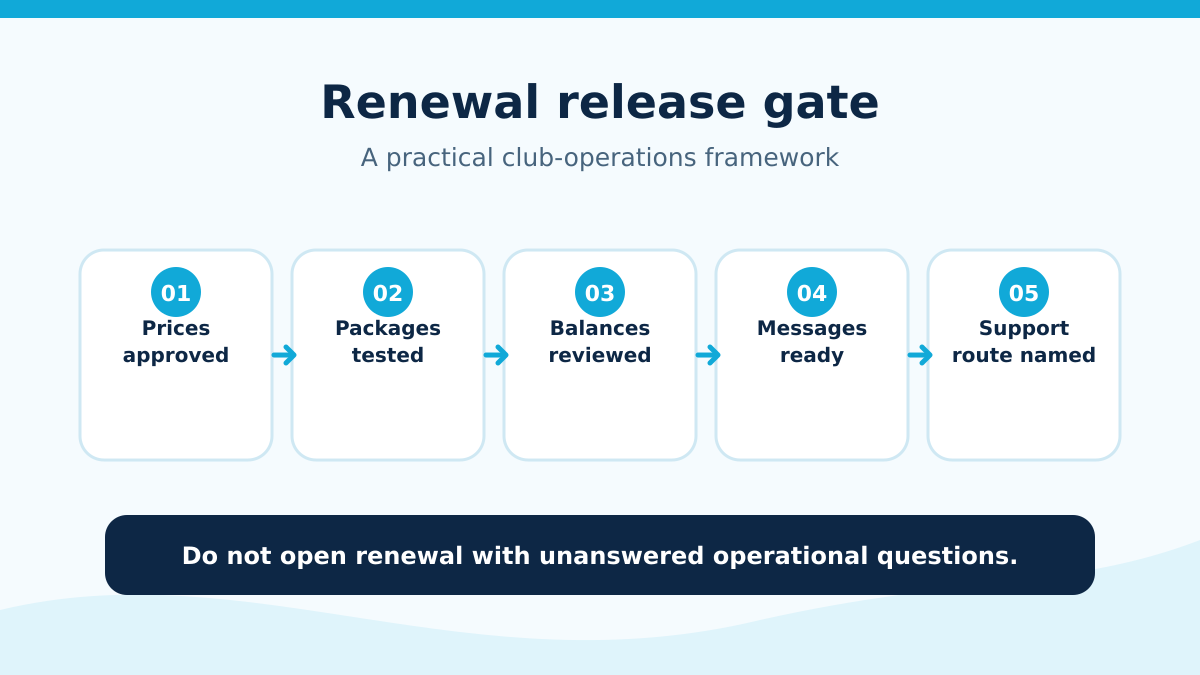

Renewal release gate covering prices, packages, balances, messages, and support.
Open renewals only after prices, packages, balances, messages, and support routes pass review.

6. Use a release gate, not a hopeful date

Keep the target date, but require a short go/no-go review. Prices approved, packages tested, balances reviewed, messages proofed, links checked, staff rehearsed, and support coverage named should all be visible.

If one critical condition fails, choose a later date and tell stakeholders why. A controlled delay is better than opening a process the team already knows is incomplete.

Questions to answer:

  • Are rules approved?
  • Did tests pass?
  • Are links live?
  • Is staff coverage ready?
  • Who gives the final go?

The launch date represents readiness, and leadership can see the reason for any change.

7. Review the first days and adjust carefully

Watch where members stop, which questions repeat, what staff cannot see, and what finance must correct. Distinguish a training issue, a confusing message, a policy gap, and a system defect before changing the process.

Use a daily review at first, then reduce the cadence when the flow stabilizes. Preserve the approved rule while testing a correction; do not create a new exception for each caller.

Questions to answer:

  • Where do members stop?
  • Which questions repeat?
  • What needs escalation?
  • What can be clarified today?
  • What requires approval?

The club improves the renewal without losing consistency or rewriting policy in real time.

Follow one realistic club example

A club wants to open renewals on February 1. Working backward reveals that package approval is due in December, balance cleanup must finish in early January, configuration testing needs a full week, staff rehearsal must occur before the first reminder, and the support owner will be unavailable on the original launch day. The club moves release by three days and opens with completed answers instead of beginning on time with known gaps.

Use the example as a rehearsal, not as a promised result. Replace its assumptions with your club’s approved rules, actual volumes, responsible people, and operating calendar. The goal is to make the next decision observable: another staff member should be able to tell what happened, why it happened, and what must happen next.

A practical readiness checklist

  • Define the usable opening-day account.
  • Name every required form and status.
  • Approve prices and package rules.
  • Review balances, credits, refunds, and disputes.
  • Test ordinary and exception cases.
  • Rehearse with actual staff roles.
  • Create audience-specific reminder waves.
  • Verify every link and deadline.
  • Name support coverage and escalation.
  • Use a documented go/no-go decision.

Keep a decision ledger beside the working plan

A checklist shows whether a task is complete; a decision ledger shows why the club chose the rule behind it. For each material choice, record the question, the approved answer, the approving role, the effective date, the source document or meeting, and any condition that would require another review. Keep the language brief enough that the people operating the process can use it.

The ledger is especially useful when reasonable people remember the discussion differently. It prevents a draft suggestion, an old exception, or a vendor demonstration from quietly becoming policy. If no authorized decision exists, mark the item open and name the person responsible for bringing it to the correct group. “Open” is a useful status; it is better than a confident answer nobody actually approved.

Include the decisions that feel obvious today. Staff changes, board turnover, and the pressure of a busy season can make an unwritten assumption expensive to reconstruct. A new employee should be able to see which rule applies, when it began, and where to ask for a change. Archive superseded versions instead of deleting them so the club can explain historical records under the policy that existed at the time.

Review the ledger from the perspective of club managers and membership committees. The operational owner should confirm that the answer can be carried out. Finance should confirm how money or reporting is affected when relevant. The member-facing owner should confirm that the explanation is understandable. A short cross-role review often exposes a gap that a longer single-department meeting misses.

Rehearse the handoff, not just the happy path

Choose one ordinary case and one difficult case, then let the people who will run the process complete it from beginning to end. Give them the approved rule and sample information, but do not coach every click or conversation. Watch where they pause, switch tools, ask for permission, or create a side note. Those pauses reveal where the operating design still depends on memory.

For the difficult case, change one condition that matters: a deadline has passed, a balance conflicts, an eligible person becomes ineligible, a staff member lacks access, or the expected record cannot be found. The purpose is not to surprise employees. It is to confirm that the process provides a safe next step when the routine path stops. Staff should know what they may decide, what they must escalate, and how to leave a useful record for the next person.

Ask another employee to pick up the saved result without hearing the rehearsal conversation. Can they identify the current state, the last decision, the responsible owner, and the next date? If they must call the original employee to understand the record, improve the labels, notes, ownership, or workflow before launch. A handoff is successful when context survives the shift change.

Repeat the rehearsal after a material correction. Testing the edited version matters because a fix in one place can create inconsistency somewhere else. Re-read the member message, account or work record, report, and staff instruction together. The club is ready when the same approved answer remains visible across the complete journey.

Measure the first cycle without inventing a success story

Decide in advance what the club will observe during the first cycle. Useful measures may include incomplete cases, unresolved exceptions, repeat contacts, manual corrections, processing time, or the number of records waiting for an owner. Choose only measures that the club can define and collect consistently. A small trustworthy set is more useful than a dashboard filled with ambiguous counts.

Pair counts with a review of the underlying cases. A rise in questions may mean the message is unclear, the policy is new, or members are paying closer attention; the number alone does not identify the cause. Read representative records, talk with the employees doing the work, and separate a policy gap from a training need, a data problem, and a product defect before choosing a response.

Set a review date and an owner for each measure. During the review, keep completed changes separate from recommendations. Record what evidence supports the conclusion, what remains uncertain, and whether the next step requires management or board approval. Do not claim saved money, retained members, or better performance unless the club has a sound baseline and a method that supports that conclusion.

The most useful outcome of the first cycle may be a narrower rule, a clearer message, or a better exception route. Treat those corrections as part of operating the process, not as evidence the plan failed. A practical system makes learning visible and controlled while preserving the decisions that still apply.

Connect the decision to one operating record

PoolPulse connects seasonal packages, renewal and billing rules, discounts, eligibility checks, capacity logic, and waitlists with club operations. Explore the relevant PoolPulse workflow .

A connected platform does not remove the need for policy, ownership, or judgment. It should make the approved rule easier to execute, keep the result beside the member or operating record, and give the next authorized person enough context to act. Ask to see the complete journey—including an exception—using sample information that matches the club’s real process.

For a related operating exercise, connect the renewal plan to verified staff availability .

Choose the next step

Assign one person to complete the checklist, one person to review it from another role, and one date for the next decision. Keep unknowns visible. If a material question remains unanswered, make resolving it the next gate instead of treating silence as approval.

Bring your opening date and one membership package to a PoolPulse walkthrough to map the renewal calendar around your real rules. Schedule a personalized PoolPulse walkthrough . You can also review current PoolPulse pricing before the conversation.

Related Articles

Explore related insights.

Find more practical guides, best practices, and ideas for running your club.

Facilities lead and club manager review maintenance priorities on a quiet autumn pool deck.Facility Operations10 min read

Your Offseason Repair List Is Too Long. Here Is How to Decide What Moves First.

A decision framework for turning a long offseason repair list into owned, timed, and verifiable work.

Read article ->
A miniature swim and tennis club with cyan paths connecting its spaces, with the headline Show Us the Whole Workflow.Club Operations14 min read

The Demo Looked Great. What Would Prove This Platform Works for Your Club?

Go beyond a polished software demo. Bring one everyday club task, let staff try it, and check what happens from the member's request to the final follow-up.

Read article ->
A closed pool gate and blank cyan notice panel under an overcast sky, with the headline Did They Get the Message?Club Operations14 min read

The Pool Is Closed. Did the Right Members Get the Message?

A closure notice needs to reach the families whose plans have changed. Keep lessons, reservations, staff, and reopening updates covered with a simple plan.

Read article ->

Want to see if PoolPulse is a good fit for your club?

Book a walkthrough and we'll show you exactly how PoolPulse can help based on your club's needs, goals, and current processes.

Schedule a WalkthroughSee a Demo First ->
